M21 - Limerick to Rathkeale/Foynes [Adare bypass under construction; remainder pending]

14243444648

Comments

  • Registered Users, Registered Users 2 Posts: 582 ✭✭✭annfield1978


    Missing link will be part of a separate Employer Design Contract procured through a Framework so wont be visibile on E Tender



  • Moderators, Sports Moderators Posts: 13,464 Mod ✭✭✭✭Cookiemunster

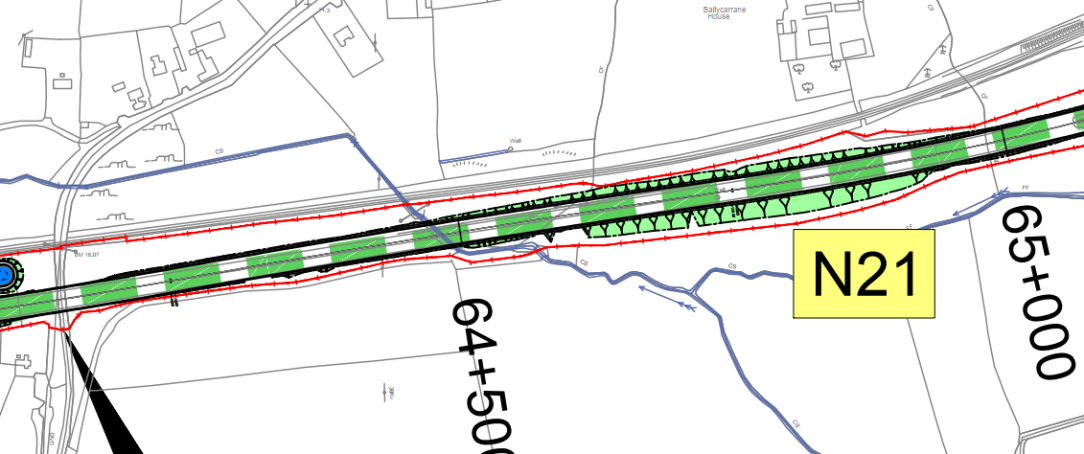

    I was having a look at the design drawings on foyneslimerick.ie and it could indeed be works for the missing link.

    The N21 is on an embankment between the Monearla Bridge and the end of the current dual carriageway and that will need to be widened slightly to allow the road to be widened. This seems to match with the location of the works in the notice.



  • Registered Users, Registered Users 2, Paid Member Posts: 3,296 ✭✭✭KrisW1001


    The notice says “Embankment Construction Works”, so that could be as you say. The bridge itself will be a big job, though.

    But you’d imagine that if this road was being built, the local TDs and councillors would be out with the megaphones taking credit for it. If this is anything to do with N21 (and it may not be), I suspect it’s just enabling works, services and/and groundwork being done while the necessary plant is already nearby for the Adare bypass.

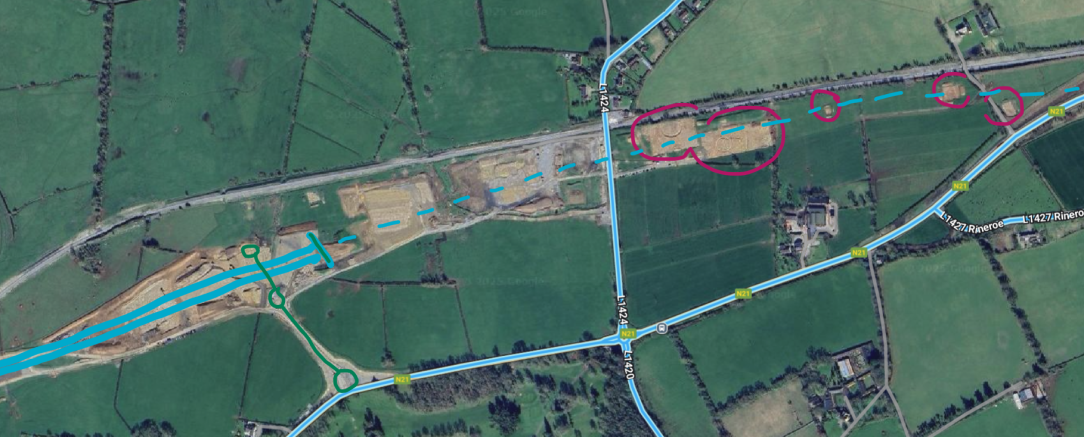

    What is very promising is that the archaeological survey works for the shortened bypass programme actually extend all the way to the tie-in with the existing road (digs are circled in red below). This will allow the construction to be continued without any additional delay.

    Post edited by KrisW1001 on


  • Moderators, Science, Health & Environment Moderators Posts: 14,964 Mod ✭✭✭✭marno21


    Is the Monearla bridge being retained as is for the M21 upgrade? I had thought it was.



  • Moderators, Sports Moderators Posts: 13,464 Mod ✭✭✭✭Cookiemunster


    The bridge is staying. You can see from the design drawing that it's not part of the scheme. There'll just be no hard shoulder underneath it like the bridges on the Nenagh bypass. The motorway will diverge from the N21 just West of the bridge. But an overpass will need to be built over the L1424.



  • Advertisement
  • Registered Users, Registered Users 2 Posts: 944 ✭✭✭pajoguy


    Expected delivery date for the Adare bypass is February 2027. That is what they are currently on track for.

    This extension is being undertaken under TII Frameworks as I understand it. Priority Construction are on site now. They may be doing earthworks and drainage and separate contractors for structure, pavement construction, signage etc.

    This is my understanding of what is happening.



  • Moderators, Science, Health & Environment Moderators Posts: 14,964 Mod ✭✭✭✭marno21


    https://www.foyneslimerick.ie/_files/ugd/1cba1b_5e9a6202308b4445ba41e0a3417da18b.pdf

    Not having to rebuild Monearla Bridge is a big boost.

    From the above map, the total between the underbridge of the Adare GSJ and Monearla Bridge is 2.1km. The first 650m of this is west of the L1424 which has already had work commenced per the drone videos. It's 1.5km from there to Monearla Bridge which has a total of a culvert and a stream bridge, and the L1424 underbridge.

    It would be a possibility that into 2026 as earthworks conclude on the rest of the scheme they can go hammer and tongs at this stretch, which is a particularly easy one. There is no fundamental reason it could not be complete in 18 months.

    Hopefully the roadworks notice above is the start of this.



  • Registered Users, Registered Users 2, Paid Member Posts: 3,296 ✭✭✭KrisW1001


    Measuring from aerial photos, there’s around 17 metres of road between the two armoured barriers here (give or take 20 cm or so). A Type 1 DC without shoulders is 4x 3.5 m traffic lanes, plus a 2.6 metre median reserve = 16.6 metres. Yes, it’s a bit of a squeeze but it’ll fit.

    Looks like this route was expected to be no wider than a 2+2 in future (i.e., a paved width of 16.5 m), which makes sense given that when this road was built, M21 was projected to to take a different route entirely: starting as a spur from M20, and bypassing Adare to the south.



  • Registered Users, Registered Users 2 Posts: 16 cameltoe86


    Another update from Adare Bypass page



  • Moderators, Sports Moderators Posts: 13,464 Mod ✭✭✭✭Cookiemunster


    That ends rather abruptly. Hopefully the reupload it with the full video.



  • Advertisement
  • Registered Users, Registered Users 2 Posts: 1 divineblessings


    Great progress. Non-trivial chance the Ryder Cup might be cancelled (Greenland etc)?



  • Registered Users, Registered Users 2 Posts: 1,180 ✭✭✭lordleitrim


    Hopefully not. 🙏 Separately, isn't it fair to say many motorway projects since the 2000s (once they eventually start construction) tended to open up to several months before their official target date? Could we see a Spring 2027 opening if there are no unforseen obstacles or delays and favourable weather conditions?



  • Registered Users, Registered Users 2 Posts: 159 ✭✭Pale Red


    Ryder Cup has little to do with this project - other than splitting out a section to have done before it. I think if RC was cancelled today we would see the missing link starting and probably finished by next Summer.



  • Registered Users, Registered Users 2 Posts: 944 ✭✭✭pajoguy




  • Registered Users, Registered Users 2 Posts: 2,658 ✭✭✭MayoSalmon


    What does Greenland have to do with the Ryder Cup?!



  • Moderators, Science, Health & Environment Moderators Posts: 14,964 Mod ✭✭✭✭marno21


    Until such time as there’s a clear impact of the latest developments in US foreign policy on the development of the M21 motorway in Co. Limerick, there’s no real need to discuss it on this thread



  • Registered Users, Registered Users 2 Posts: 159 ✭✭Pale Red


    Strong suspicion that earthworks are part of building the missing link. Has there been an announcement - nothing on the bypass website.



  • Moderators, Science, Health & Environment Moderators Posts: 5,760 Mod ✭✭✭✭spacetweek


    Speculation so far, no official confirmation.



  • Registered Users, Registered Users 2 Posts: 861 ✭✭✭Cushtie


    Any word on when they will start the rest of this project [west of Adare to Foynes] ?

    Will they move on to it soon enough or will it be a totally separate project to be started when the Adare bypass part is complete. I'm aware they have done the fencing, archeological etc.



  • Registered Users, Registered Users 2, Paid Member Posts: 22,094 ✭✭✭✭Bass Reeves


    I think a certain amount of work has started on it. AFAIK the contract is given out already)

    Slava Ukrainii



  • Advertisement
  • Registered Users, Registered Users 2 Posts: 171 ✭✭Tockman


    New newsletter out

    The Q4 2025 newsletter for the Foynes to Limerick Road (Adare Bypass) project reports that the development remains on track for completion by the end of Q2 2027. Despite challenging weather conditions during the quarter, the project has transitioned focus from major earthworks to drainage and structural construction.

    Project Progress & Key Stats

    • Workforce: There are over 300 personnel currently on-site, with over 350,000 total hours worked.
    • Earthworks: Cut and fill operations are now more than 90% complete.
    • Drainage: Over 25% of the drainage pipework has been installed.
    • Structures: 13 of the 14 planned underpasses and culverts were installed by the end of 2025.
    • River Bridges: The River Maigue sub-structure is nearly finished, and manufacturing of its steel beams is almost complete for delivery in Q1 2026. Other river bridges (Greanagh A, Greanagh B, and Clonshire) have substantially complete sub-structures.

    Traffic Management Updates

    • L-8025: Reopened to traffic in early January 2026.
    • N21 Adare Roundabout: Online construction works are expected to begin in late Q1 or early Q2 2026, which may cause traffic delays and require nighttime closures for surfacing.
    • Public Safety: Residents are urged to take care near site entrances and comply with temporary traffic restrictions, including reduced speed limits.

    Look Ahead (Q1 2026)

    • Rock Blasting: Operations near Croagh will continue.
    • Bridge Work: The Clonshire bridge deck will be poured, and beams will be placed on the two Greanagh bridges and Underbridge UB09.
    • Upcoming Structures: Abutment walls for the Adare Junction (UB10) will commence, and the final culvert (M21-C7) is scheduled for installation.


  • Registered Users, Registered Users 2 Posts: 1,124 ✭✭✭Vanquished


    First confirmation of sorts that the "missing link" section from the future Adare GSJ to the existing N21 DC is progressing.

    https://www.limerickleader.ie/news/motoring/2018538/final-phase-of-bypass-through-limerick-village-fast-tracked-for-ryder-cup.html



  • Registered Users, Registered Users 2, Paid Member Posts: 3,296 ✭✭✭KrisW1001


    Good to see.

    The main project looks to be ahead of schedule, which is why I suspect they’ve activated this part. The online upgrade should be done within 12 months.



  • Moderators, Sports Moderators Posts: 13,464 Mod ✭✭✭✭Cookiemunster


    No sign of a video yet, but theres a gallery up for February.

    https://www.adarebypass.ie/february-2026/

    The Western Greanagh River bridge has had its beams installed and a huge crane is being setup for install the beams on the Eastern Greanagh River bridge.



  • Moderators, Sports Moderators Posts: 13,464 Mod ✭✭✭✭Cookiemunster


    Another excellent video from the project team.



  • Moderators, Science, Health & Environment Moderators Posts: 14,964 Mod ✭✭✭✭marno21


    Things seem to be going well especially in light of how challenging it has been for the last while.

    Unfortunately the video above only covers the strech covered by the contract so its hard to ascertain what's going on at the eastern end.

    Is the actual span for the motorway at the Adare interchange covered under the Adare bypass contract? The Adare bypass contract can function without the span complete. It doesn't look like much is happening with the actual motorway part there.



  • Registered Users, Registered Users 2 Posts: 159 ✭✭Pale Red


    To my layman's eye, it looks like early ground works on the missing link from 13:45.



  • Moderators, Sports Moderators Posts: 13,464 Mod ✭✭✭✭Cookiemunster


    The interchange bridge and the slips to the west are included in the contract.

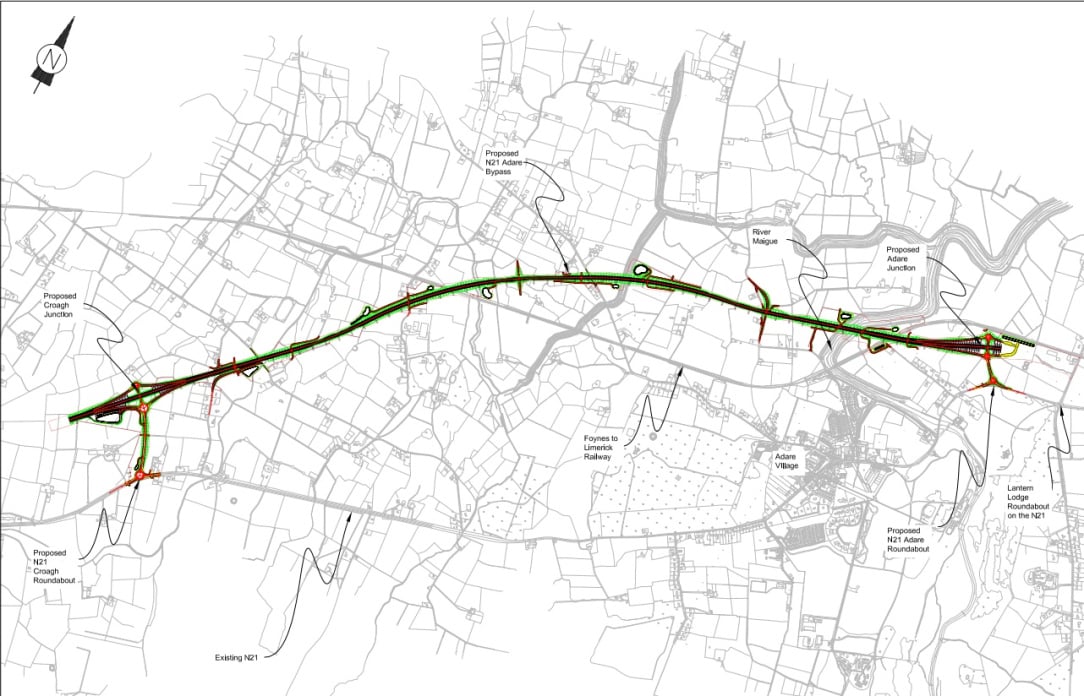

    17718464591334024927788556241512.jpg 1000021856.jpg


  • Registered Users, Registered Users 2 Posts: 1,180 ✭✭✭lordleitrim


    There is definitely digger activity the few times I've passed the " missing link" section in the past month...it seems strange that it is not being mentioned in any formal literature or 3 months look ahead updates being provided by the official channels.



  • Advertisement
  • Registered Users, Registered Users 2, Paid Member Posts: 2,325 ✭✭✭Hibernicis


    Drove passed yesterday (got distracted and accidentally drove through Adare on a Sunday afternoon, Groan) and it's fenced off and there was heavy groundworks equipment in the vicinity.

    That is some crane they have for the second Greanagh River bridge.
